How to Plan a Commercial Asphalt Paving Project Without Disrupting Your Business

Updated

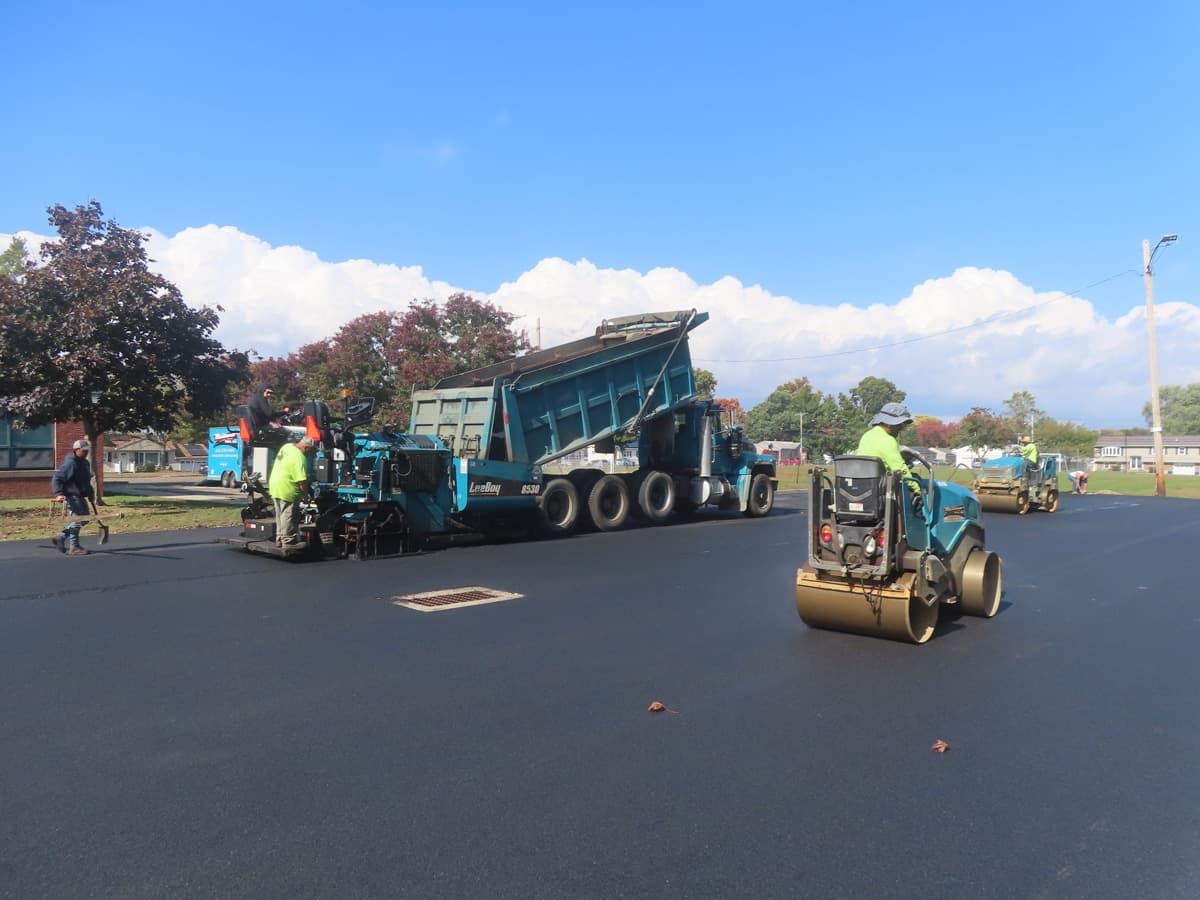

Maisano Brothers Inc. crew paving a new commercial paving lot

Before you ask contractors to bid, our checklist of what a commercial parking lot paving estimate should include shows the scope items to compare line by line.

Repaving a parking lot at a property that is open for business means planning the work around customers, tenants, employees, deliveries, and emergency access, not just around the paving crew. Whether you manage a retail plaza, office park, medical building, or industrial site, the goal is to keep as much of the property usable as the work safely allows and to tell people clearly what will change and when.

Short answer: Many commercial lots can be paved in phases so part of the property stays usable while one section is worked on, but no contractor can promise that every entrance, space, or route stays open. Whether phasing works, and how much of the lot stays available, depends on the lot's layout, safety needs, access for emergency and delivery vehicles, weather, and the scope of work. Some phases may need to close an entrance, an accessible route, a loading area, or the whole lot for a time. Plan the phases with your contractor after a site visit, agree on who notifies tenants and visitors, and send a clear notice before each phase.

Key Takeaways

  • Planning starts with a site evaluation of pavement condition, drainage, traffic flow, and the areas that need repair or replacement.
  • Phasing the work in sections can reduce disruption to customers, employees, and deliveries, but some entrances, accessible routes, delivery areas, or even the entire lot may need to close for a time.
  • How well phasing works depends on layout, safety, access, weather, and scope, so the plan has to be built for your specific site.
  • Clear notices before and during the project, covering closures, parking changes, dates, and access routes, prevent most of the confusion.
  • The job isn't finished at the last roller pass: striping, signage, and reopening confirmation all affect when the lot is usable again.

Can my business stay open while the parking lot is paved?

Often, partly. A phased plan can keep some parking, an entrance, and a route to the building available while another section is closed. It cannot guarantee uninterrupted operation. These five factors decide how much of your property can stay usable:

  • Layout. A lot with two entrances and separate parking fields is easier to split than a single narrow lot with one driveway.
  • Safety. Vehicles and pedestrians have to be kept clear of milling machines, pavers, rollers, and trucks, which can rule out sharing a drive lane with the work zone.
  • Access. Fire lanes, emergency access, accessible parking and routes, and delivery and trash access each need a plan for every phase.
  • Weather. Rain or cold can postpone a phase, which keeps closures and detours in place longer than planned.
  • Scope. A surface overlay can usually be phased more simply than excavation, base repair, or drainage work that leaves an area open and unsafe to drive on.

Common ways to stage the work

ApproachWhen it can workLimits to plan for
Sections or halves of the lotLots with more than one parking field or a layout that can be split with a safe traffic pathFewer spaces during each phase; more total days than doing the lot at once
Keeping one entrance or drive lane openSites with two or more entrances, or a drive lane wide enough to separate from the workThe open entrance may have to close briefly when the crew ties new pavement into it
Off-hours or slower-period schedulingProperties with clear quiet times, where the contractor can schedule work thenDepends on the contractor's availability, local rules, lighting, and safety; confirm it in writing rather than assuming it
Full closure for a short periodSmall or single-entrance lots, or work that can't be split safelyNeeds alternate parking, a delivery plan, and the most advance notice

These are planning options, not commitments. The right mix comes from a site visit, and a phased plan usually adds working days in exchange for keeping part of the property usable. For how long each stage of the work typically takes, see our commercial parking lot paving timeline.

What should the site evaluation cover?

Before any phasing plan is drawn up, request an on-site evaluation from a commercial paving contractor. Permits, specifications, and contractor qualifications depend on the project and the municipality, so confirm which ones apply to yours; a residential Home Improvement Contractor registration, for example, does not cover every commercial obligation. A proper evaluation will include:

  • Current pavement condition
  • Drainage and grading issues
  • Entry and exit points
  • Traffic flow patterns and bottlenecks
  • Heavy-duty zones like loading docks or drive lanes

This step shows what needs to be repaired, replaced, or improved, and which parts of the work can be staged separately.

What should you look for in a commercial paving contractor?

A commercial job at an occupied property needs a team that understands:

  • Work-zone safety around customers, employees, and vehicles
  • Commercial equipment access and logistics
  • Communication with multiple stakeholders (tenants, property managers, owners)
  • Striping, signage, accessible parking, and fire lane markings

Ask for examples of previous commercial work, especially on properties similar to yours. Retail centers have their own pressures, such as storefront visibility and tenant lease obligations; our retail and shopping center paving page covers how we approach them.

How do you plan the phases?

Divide the lot into zones with your contractor so that, where the layout allows, traffic, deliveries, and parking continue in the areas that stay open. Agree on a site-specific access and traffic-control plan before construction, and identify in advance any periods when entrances, accessible routes, delivery areas, or the entire lot must close.

For each phase, the plan should state:

  • Which areas, entrances, and drive lanes close
  • Where people park instead, and when vehicles must be moved
  • The open pedestrian route and accessible route to each open entrance
  • The route for deliveries, trash pickup, and service vehicles
  • Who confirms the area is ready to reopen

Phasing reduces disruption, but it rarely removes it. If you want after-hours or weekend work, ask whether it is possible for your site and put the agreed hours in the contract.

How should you communicate with tenants and visitors?

Once your schedule is set, notify everyone affected well in advance. Send emails, hang signs, and post online updates covering:

  • Where to park
  • When each section will be closed
  • How long each phase is expected to last, subject to weather
  • Who to contact with questions or concerns

What to Include in a Tenant or Resident Paving Notice

A useful notice answers the questions people would otherwise bring to the property office. It usually comes from the property owner, manager, or association, using schedule details from the contractor. For condominium and apartment communities, our HOA and property management page covers how we work with boards and managers. Whoever sends it, include:

  • Dates and hours: the planned work days and times, with a clear note that dates depend on weather.
  • Affected areas: which sections, entrances, and drive lanes close in each phase.
  • Alternate parking: where to park instead, and when vehicles must be moved out of the work area.
  • Pedestrian and accessible access: which walkways and building entrances stay open, and the accessible route to each open entrance.
  • Deliveries and services: instructions for deliveries, trash pickup, and service vehicles, and a reminder to pass them on to vendors.
  • Contact details: a named person to call or email with questions during the work.
  • Weather changes: how people will hear about a postponed phase, and where updates will be posted.
  • Reopening confirmation: how people will be told an area is open to traffic again, so no one assumes.

Example notice

Example only. Every detail below is illustrative; replace it with your property's actual schedule, areas, and contacts.

Parking lot paving: north lot (Phase 1 of 2)

Dates: Tuesday–Wednesday, weather permitting, during daytime working hours.

Closed: The north lot and the north driveway entrance. The south lot and south entrance stay open.

Where to park: The south lot or the overflow area behind the rear building. Please move vehicles out of the north lot by the evening before work begins; vehicles left in the work area can delay the job.

Walking and accessible access: The main building entrance stays open from the south lot. Accessible parking is available in the south lot near the main entrance, with a marked route to the door.

Deliveries: Please have deliveries use the south entrance during the work and share this notice with your regular vendors.

Questions: Contact the property management office by phone or email.

If weather delays the work: A new date will be posted on the lobby notice board and sent by email.

Reopening: Please do not drive on the new pavement until the north lot is confirmed open. The reopening time will be posted and emailed.

Add a simple closure map

A marked-up site plan or aerial image often explains a closure faster than text. Any map you share should be clearly labeled as a planning map and updated if a phase moves. For each phase, mark:

  • The dates for that phase
  • Closed areas, drive lanes, and entrances
  • Open entrances and alternate parking
  • The pedestrian route and accessible route to each open entrance
  • The delivery and service-vehicle route
  • Where temporary signs, cones, or barriers will be placed

Traffic cones placed on a commercial parking lot to guide traffic during an asphalt paving project

Traffic cones help direct vehicles and pedestrians safely during a commercial asphalt paving project.

Who provides temporary signage and traffic control?

During paving, your site may need temporary signs or cones to redirect traffic and footpaths. The contract should say who supplies, installs, and maintains each of these, and who sends customer and tenant notices:

  • Safety cones or barriers
  • Temporary directional signs
  • Accessible-route detours if needed
  • Pedestrian guidance signs for walkways

A clear plan keeps everyone safer and helps maintain accessible routes in the areas that stay open.

What happens after the asphalt is down?

The lot isn't fully usable until the finishing work is done:

  • Fresh parking lot striping
  • Accessible parking markings and access aisles
  • Crosswalks, arrows, and fire lane paint
  • Signage, curbing, and wheel stops if needed

Schedule line striping as part of the plan, since markings go down only once the surface is ready for them, and don't announce that an area is open until the contractor confirms it can take traffic. Striping alone does not establish ADA compliance: the number of accessible spaces, aisle widths, slopes, accessible routes, and signs all matter, as the U.S. Department of Justice explains in its guidance on restriping parking spaces.

After that, protect the investment with routine crack sealing, drainage checks, and cleaning. Sealcoating is optional. Many lots are resealed about every two to three years, but that is typical guidance rather than a requirement: whether and when to reseal depends on the pavement's condition and the product, and the product label's instructions apply.

Many property managers put that work under a long-term maintenance contract so it happens on schedule instead of after complaints. Our yearly parking lot maintenance programs plan crack sealing, patching, sealcoating, and striping by season, with the work and pricing set out in writing.

What if you manage more than one property?

Owners and managers with several sites can apply the same planning method to each one, but each lot still needs its own site visit and phasing plan, because layout, access, and local requirements differ. Our national commercial paving page explains how we work with multi-site owners outside Connecticut.

Related commercial projects

Plan your project with Maisano Brothers Inc.

Maisano Brothers Inc. has been paving Connecticut since 1967 and provides commercial parking lot paving across Connecticut and nationally. Planning paving at an occupied property? Request a free written estimate after a site visit, and ask for a phasing and communication plan with it, so closures, access, and weather contingencies are worked out before the first notice goes out.

Frequently asked questions

Can a parking lot be paved without closing my business?

Often in part. Many lots can be paved in phases so some sections, an entrance, and a route to the building stay open while other areas are worked on. It can't be guaranteed: layout, safety, access, weather, and scope may require closing an entrance, an accessible route, a delivery area, or the entire lot for a time.

Who notifies residents and businesses about a paving closure?

Usually the property owner, manager, or association board, since they hold the tenant and resident contacts and know their own lease or community obligations. The contractor supplies the schedule, work zones, and phase details the notice needs. Agree on who sends what, and when, before the schedule is final.

What changes when weather delays a phase?

The dates for that phase, and often every phase after it. Parking, access, and delivery arrangements may need to stay in place longer too. Send an update as soon as the new date is set, say whether vehicles still need to be moved, and don't announce reopening until the contractor confirms the area can take traffic.

How are deliveries and accessible routes coordinated during paving?

List regular deliveries, trash pickup, and service vehicles before the schedule is set, so the phasing can keep a route open for them or vendors can be asked to change their times. For accessibility, plan which accessible parking spaces and which route to an open entrance will be available in each phase, and mark them with temporary signs.

When can traffic go back on new asphalt?

There is no universal "full cure" date. New asphalt becomes ready for traffic mainly by cooling and stabilizing, and the timing depends on weather, the mix, thickness, and the loads it will carry. Your contractor should confirm when each area can reopen.

Planning work on a commercial lot? See our parking lot paving service for businesses, HOAs, and property managers.

Chris Maisano, CEO of Maisano Brothers Inc.

About the author

Chris Maisano

CEO, Maisano Brothers Inc. · LinkedIn

Chris Maisano is the dedicated leader of Maisano Brothers Inc., a family-owned company paving Connecticut since 1967. Building on the legacy of his father and uncle, who started out plowing snow and taking on paving jobs with a pickup truck in 1963, Chris has guided the company into a modern era while preserving its reputation for quality and reliability. With decades of hands-on experience in asphalt paving, milling, grading, and reclamation, he is known for delivering lasting results for residential, commercial, and municipal projects. Respected for his expertise and integrity, Chris continues to uphold the Maisano Brothers Inc. tradition of excellence, ensuring every project is completed with the same commitment to craftsmanship and customer care that has defined the company for generations.

Content Transparency Notice

We use a combination of industry expertise and AI-assisted tools to create helpful educational content. While we strive for accuracy, some information may be simplified or require updates as industry standards evolve. Our team actively reviews and refines articles to keep them accurate, useful, and up to date. We welcome and value your input if you believe there is inconsistent or inaccurate information provided. Contact us directly with any issues.

Free Estimates

Ready to start your paving project?

Request a free estimate from Maisano Brothers Inc. — Connecticut paving experts since 1967.

Call NowRequest Quote
